Activities

Preparation Activities

The preparation activities will take place between months 1 and 8 of the project, during which period the effluents from the proposed WWTPs will be defined as well as the requirements for the flexible pilot plants (FPP).

  • Goals:
  • Definition of the secondary effluents from WWTPs
  • Analysis of microplastics, eco-toxicity, antibiotic resistant bacteria, processing contaminants and pathogens
  • Definition of requirements for FPPs

Implementation Activities

Between months 6 and 12 of the project, the FPPs and the monitoring system will be designed and the plants will be constructed. Between months 13 and 42, the FPPs will be validated at the different locations. A wastewater reuse incidence study will also be carried out between months 7 and 42 of the project in the province of Almeria. During this same period, the project’s replicability strategy will be prepared. Finally, a decision support system (DSS) will be developed that, supported by the data obtained during the project, will help to find the optimal solution to implement a water reuse system for each specific case. The design will be created between months 6 and 10 of the project, while it will be implemented across the rest of the project’s life (M7-42)..

  • Goals:
  • Design, construction and validation of the FPPs
  • Design of monitoring systems
  • Replicability study in Almeria
  • Preparation and testing of the DSS
  • Prepare a project replicability strategy

Impact monitoring

The monitoring activities include the assessment of the different KPIs defined previously. Furthermore, a project environmental and socio-economic impact study will be carried out. These activities will be carried out across the entire life time of the project, from months 1 to 42.

  • Goals:
  • Monitoring of KPIs
  • Monitoring of environmental impacts
  • Monitoring of socio-economic impacts

Communication and dissemination

These activities span the entire life time of the project, from months 1 to 42. General communication activities will be carried out in addition to activities to disseminate the results obtained during the project, through technical publications.

  • Goals:
  • Preparation of a communication plan
  • Collaboration with other projects
  • Hold events to disseminate results

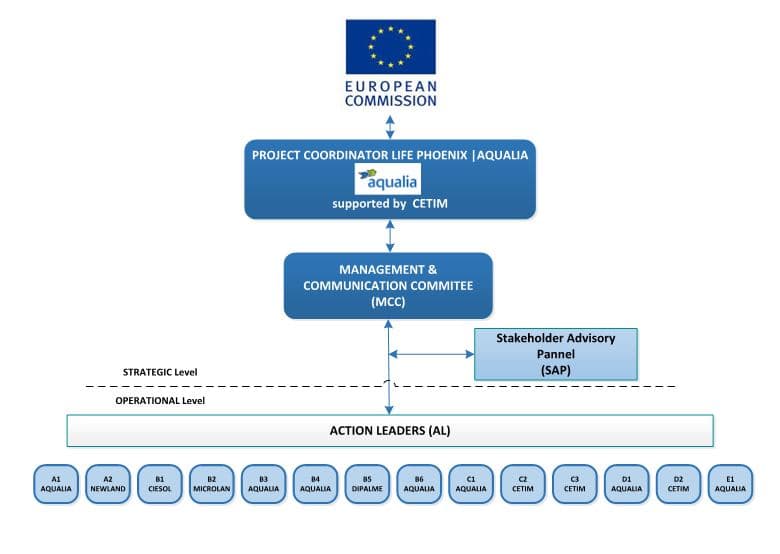

Project Management

Aqualia, with support from CETIM, is responsible for coordinating the project. Technical, administrative and economic monitoring will be performed. A partner is responsible for each activity performed, overseeing the technical actions and ensuring the quality of the results obtained.






Funding details:

Funding: LIFE Environment and Resource Efficiency

Organism: European Commision (EC)

ProjectLIFE19/ENV/ES/000278

Grant: Subsidy of 55% budget

Total funding received: 1.855.113€

With the contribution of the European Union LIFE programme LIFE19 ENV/ES/000278

This website reflects only the Consortium’s view. The European Commission is not
responsible for any use that may be made of the information it contains.

Project funded by
